Phase: Design

Estimated Completion

Winter 2027

Bronx River Addition
Soundview, The Bronx

Project Planning Jan 2024 – May 2024 Complete
Procurement May 2024 – Sep 2025 Complete
Design Sep 2025 – Fall 2026 In Progress
Construction Fall 2026 – Winter 2027 Upcoming

The Road ahead for Bronx River Addition

Current phase:

Design

Units:

226

Design–Build Team:

Fifth Avenue Builders

Last Updated:

02/01/2026

Major Resident Activities during the Design phase:

  • Residents were given the option between 3 design finishes for their kitchens and bathrooms with households voting for their favorite. The top finish will be the chosen design package for residents’ apartments.

  • Model Unit for the renovation is nearing completion and is expected to open early March 2026 to residents to tour and see what their apartments will look like.

  • Construction is expected to start Fall 2026 at Building 12 and Winter 2026 for Building 11.

Explore Project Resources

History of Bronx River Addition and the Trust

In April 2024, Bronx River Addition residents voted for the Trust! Bronx River Addition, located in the Soundview neighborhood in the Bronx, was the second NYCHA development to vote to become a Public Housing Preservation Trust site. 122 residents voted, representing 61% of heads of households. Their voices were heard, and they had ownership in shaping the future of their homes - now let’s get to work!

Fifth Avenue Builders

The Trust is using a method called Design-Build, where a single team is responsible for both the design and construction of the renovation. The Trust has selected the FAB team to deliver this comprehensive modernization at Bronx River Addition.

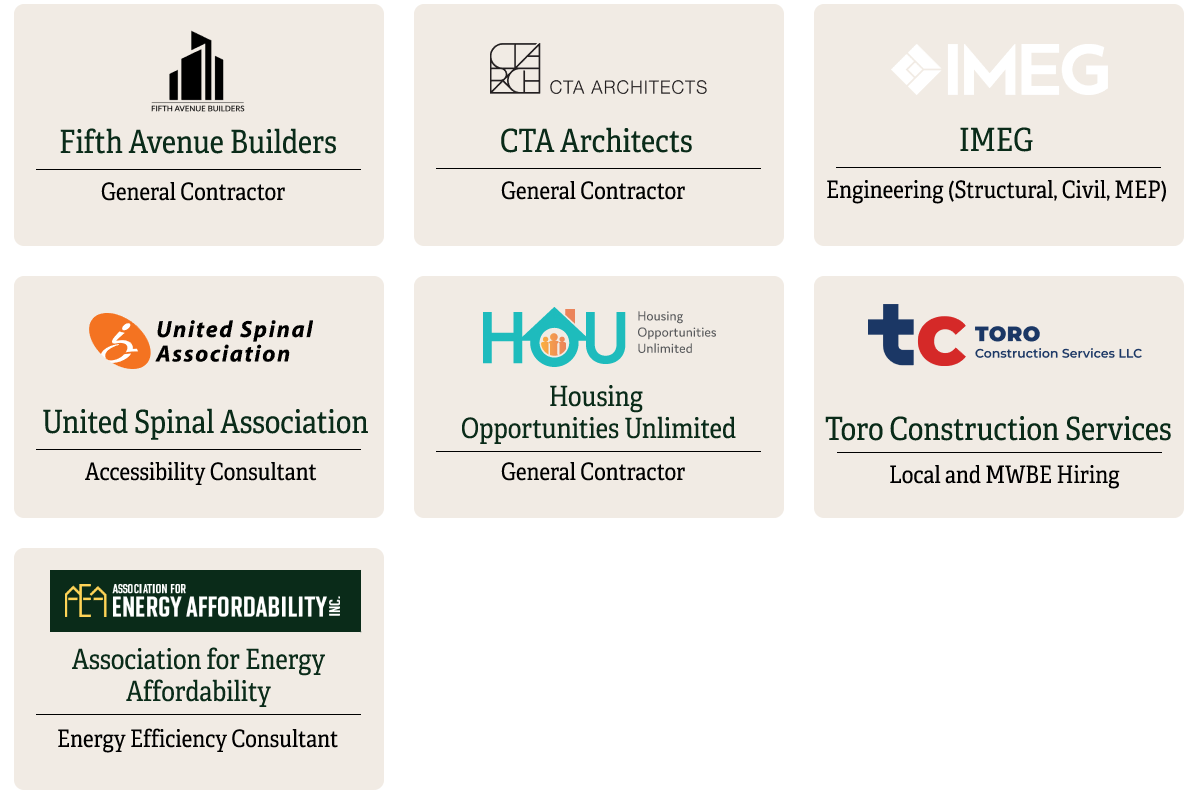

The FAB team is made up of housing modernization experts with decades of experience modernizing home environments across the United States. Their team is made up of the following organizations:

Design-Build Team

Resident Partnership at Bronx River Addition

The Trust and NYCHA began resident outreach activities in May 2024. Meaningful resident partnership has been central to the Bronx River Addition conversion from the outset. Engagement has focused on providing clear information, creating consistent opportunities for dialogue, and ensuring resident feedback informs planning and implementation.

Starting in October 2025, Fifth Avenue Builders began their resident engagement efforts as the selected design-build team.

Upcoming Activities

Upcoming Activities

Trust Engagement Office Space Now Open!

Come visit the Trust's Engagement Office at 1350 Manor Road Unit 2J, open every 1st and last Thursday from 10:00 a.m. to 4:00 p.m. Staff will be available to answer your questions or provide you updates.

Resident
Information

The Resident Priorities Report outlines the Bronx River Addition community’s key priorities for the Trust Mod renovation project — addressing everything from desired improvements to the logistics of temporary relocations. This report will be included in the procurement package for shortlisted design and construction firms, serving as a guiding document to shape their proposals.

See the library below to read the report in English and Español.

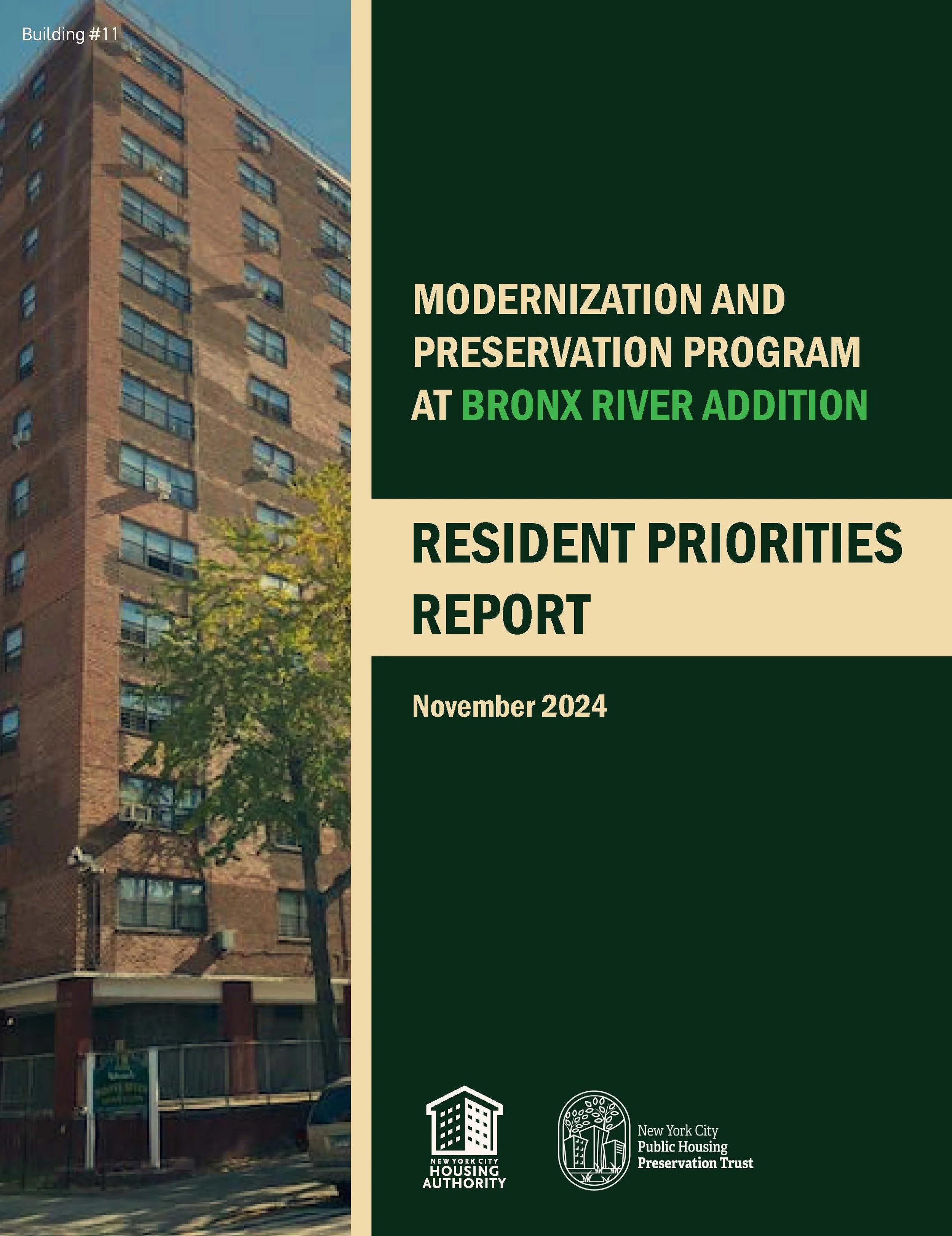

  • Cover of Resident Priorities Report - English

    MODERNIZATION AND PRESERVATION PROGRAM AT BRONX RIVER ADDITION

    Resident Priorities Report

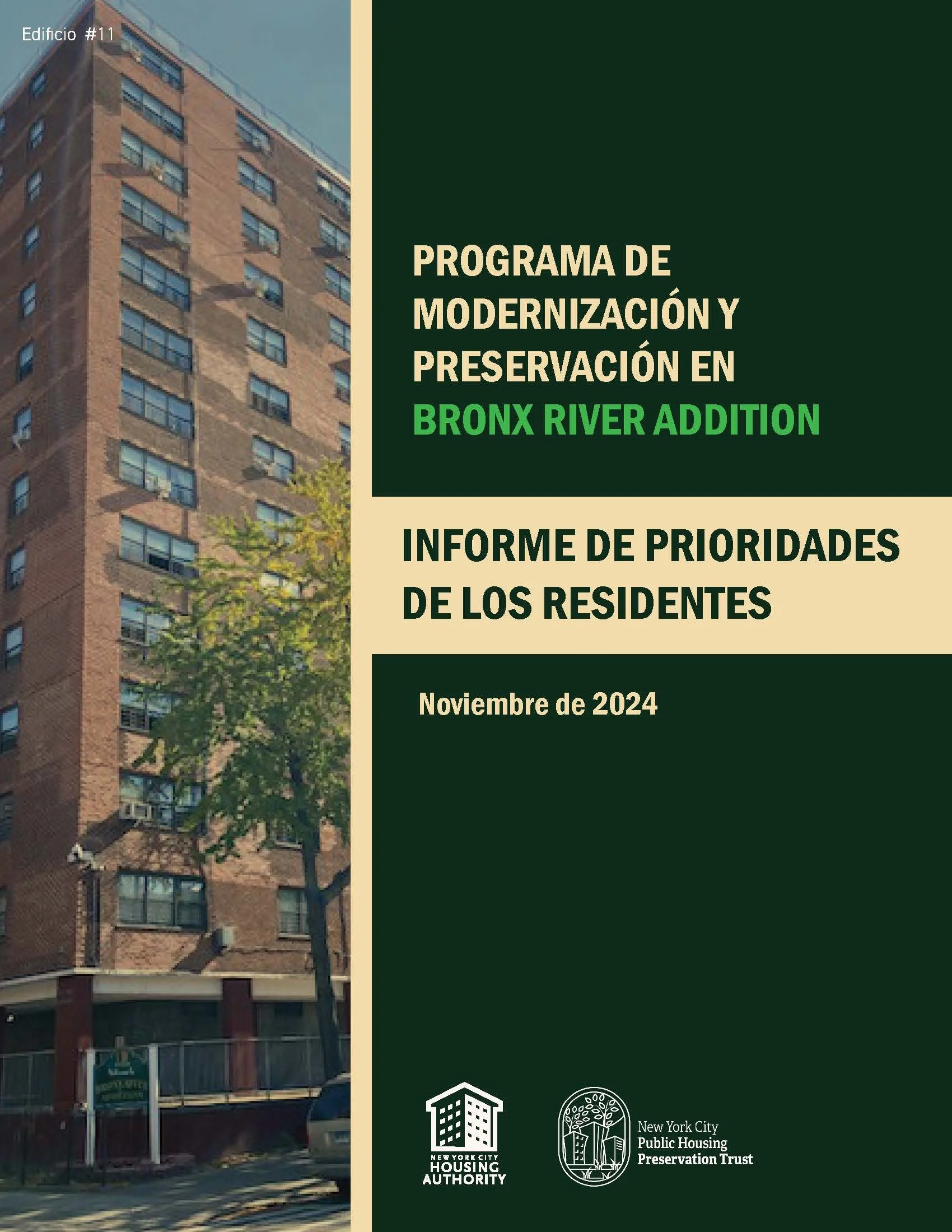

  • PROGRAMA DE MODERNIZACIÓN Y PRESERVACIÓN EN BRONX RIVER ADDITION

    Informe de Prioridades de los Residentes

 Past Activities

Resident Information Notice

The Resident Information Notice (RIN) outlines Trust’s and NYCHA’s intention to convert Nostrand to Project-Based Section 8 under the federal Rental Assistance Demonstration (RAD) program. This allows the Trust to access funding to fully modernize Nostrand while NYCHA remains the property manager. Additionally, NYCHA will provide enhanced property management, security, and social services. In the RIN, it details the rights residents will maintain under this program.

Read the RIN in English, Español, Pусский, 简体中文, and 簡體中文.
